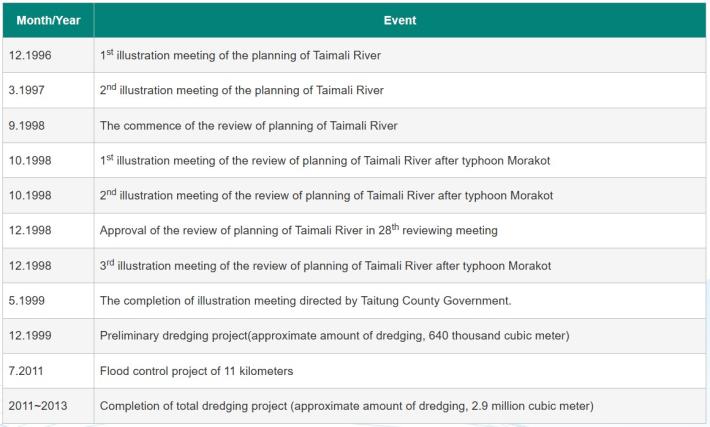

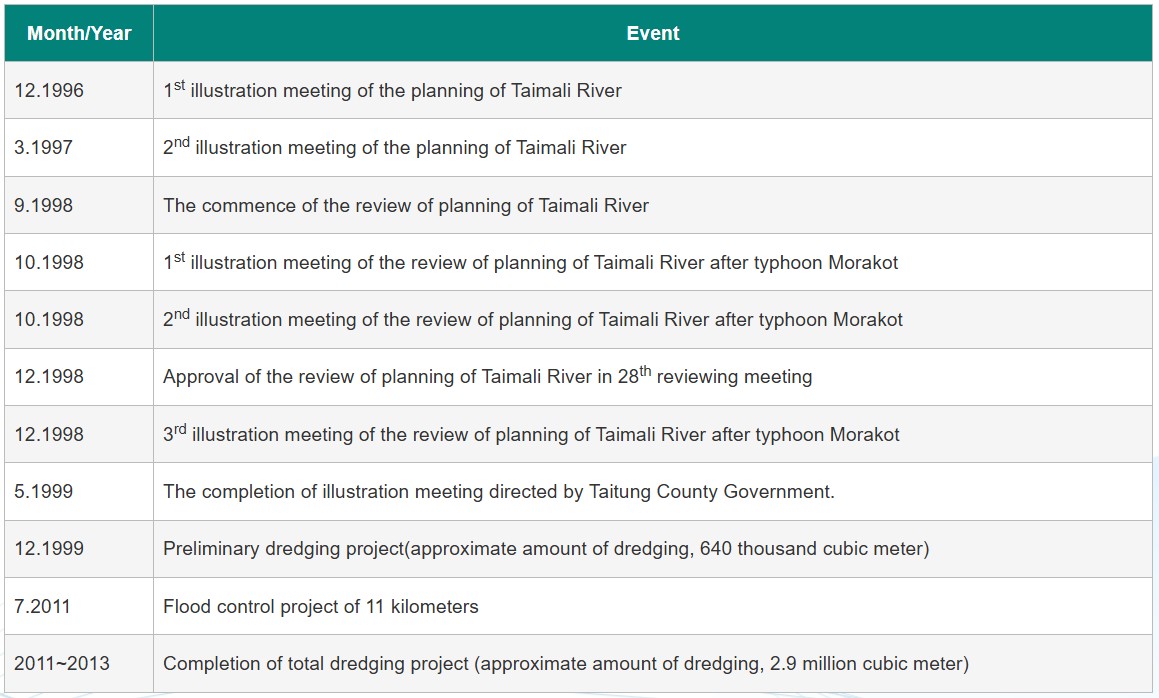

| month/year |
event |
| 12.1996 |
1st illustration meeting of the planning of Taimali River |
| 3.1997 |
2nd illustration meeting of the planning of Taimali River |
| 9.1998 |
The commence of the review of planning of Taimali River |
| 10.1998 |
1st illustration meeting of the review of planning of Taimali River after typhoon Morakot |
| 10.1998 |
2nd illustration meeting of the review of planning of Taimali River after typhoon Morakot |
| 12.1998 |
Approval of the review of planning of Taimali River in 28th reviewing meeting |
| 12.1998 |
3rd illustration meeting of the review of planning of Taimali River after typhoon Morakot |
| 5.1999 |
The completion of illustration meeting directed by Taitung County Government. |
| 12.1999 |
Preliminary dredging project(approximate amount of dredging, 640 thousand cubic meter) |
| 7.2011 |
Flood control project of 11 kilometers |
| 2011~2013 |
Completion of total dredging project (approximate amount of dredging, 2.9 million cubic meter) |
